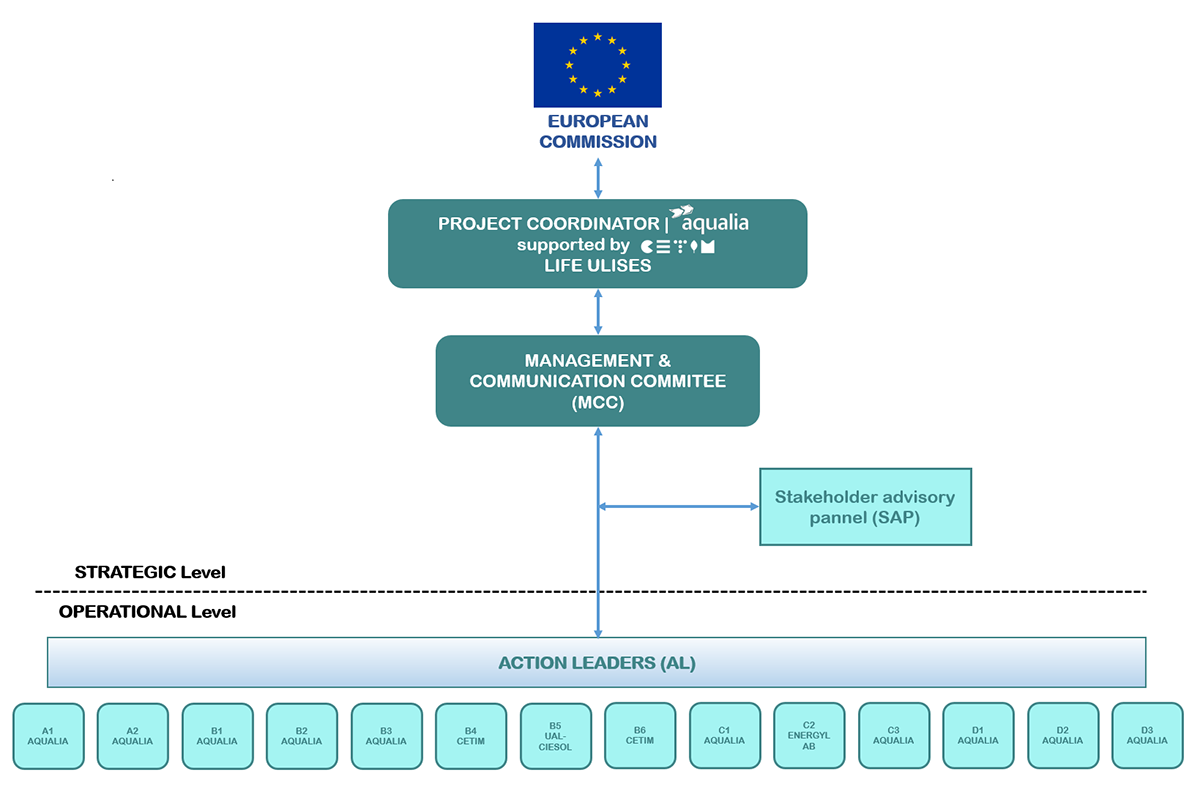

Work plan
The Project has a total duration of 36 months (3 years), from the 1st July 2019 to 30th June 2022.
The Project is divided in 14 Actions, divided in 5 main Action groups:
- Preparatory Actions
- Implementation Actions
- Monitoring of the impact of the project actions
- Public awareness and dissemination of results
- Project Management
| ACTION | PARTNERS INVOLVED | TIMETABLE |
| A1. Preliminary studies | AQUALIA, all partners | Jul 19 – Dic 19 |
| A2. Design of prototype plants, technical specifications and preliminary project | AQUALIA, all partners | Jul 19 – Mar 20 |
| B1. Construction and commissioning of the plants | AQUALIA, all partners | Jan 20 – Jun 20 |
| B2. Demonstrate the suitability of biomethane in the automotive sector | AQUALIA, all partners | Jul 20 – Jun 22 |
| B3. Implementation of water line technologies to reduce energy consumption in WWTP | AQUALIA, all partners | Jul 20 – Jun 22 |
| B4. Measure bio-products quality obtained from sludge and test | CETIM, all partners | Jul 20 – Jun 22 |
| B5. Solar tertiary treatment plant operation. Water reuse quality | UAL-CIESOL, all partners | Jul 20 – Jun 22 |
| B6. Replicability and transferability | CETIM, all partners | Jan 21 – Jun 22 |
| C1. Effectiveness of project actions on WWT process. Monitoring LIFE ULISES Key Performance Indicators | AQUALIA, all partners | Jul 19 – Jun 22 |
| C2. Evaluation of the environmental impact: Life Cycle Assessment | ENERGYLAB, all partners | Jul 19 – Jun 22 |
| C3. Evaluation of the socio-economic impact | AQUALIA, all partners | Jul 19 – Jun 22 |
| D1. Communication activities for public awareness: information, technical dissemination | AQUALIA, all partners |
Jul 19 – Jun 22 |
| D2. Dissemination of results: networking with other projects, technical dissemination | AQUALIA, all partners | Jul 19 – Jun 22 |
| E1. Project Management | AQUALIA, all partners | Jul 19 – Jun 22 |
